The Goal: Goldratt’s Theory of Constraints for Operations and Knowledge Work

· 14 min read
AI Playbook author

Local efficiency can bankrupt a plant—and a project. Eliyahu Goldratt and Jeff Cox’s The Goal teaches Theory of Constraints through a novel: the goal of a business is to make money now and in the future, and the system is governed by constraints. Optimise the bottleneck; stop celebrating busy non-bottlenecks.

Source note: This article is an original practitioner synthesis of themes from Eliyahu M. Goldratt and Jeff Cox’s The Goal: A Process of Ongoing Improvement. It is not a reprint. Support the original novel for narrative depth and the broader TOC body of work for advanced tools.

The Goal cover


0. Why this book still matters

Operations management still worships local efficiency: keep every machine busy, maximise utilisation, cut unit cost everywhere. Goldratt’s novel—via plant manager Alex Rogo—shows why that religion destroys throughput. The book is forty years old; knowledge-work organisations repeat the same mistakes with Jira tickets instead of WIP on the shop floor.

Three commitments organise Theory of Constraints:

  1. The goal is throughput, not activity. Busy ≠ valuable.
  2. Systems have constraints. Improve the constraint; everything else is secondary.
  3. Policies linger after constraints move. Inertia kills the next improvement cycle.

For AI and consulting, the constraint is rarely “not enough developers.” It is partner review, client decision latency, security approval, eval capacity, or data access.


1. The goal — make money now and in the future

1.1 Not cost-cutting theatre

Not efficiency for its own sake. Not vanity metrics on dashboards.

The goal: make money now and in the future.

Operational translations:

IncreaseDecrease (carefully)
ThroughputInventory
Operating Expense

Cutting OE while destroying throughput is false progress. Increasing inventory to keep machines (or people) busy is often false progress.

1.2 Jonah’s question

Throughout the novel, Jonah asks: what is the goal? Every local decision should be tested against system throughput—not department KPIs.

Consulting translation: If utilisation is up but client outcomes and extensions are down, you optimised the wrong thing.


2. Three measures — T, I, OE

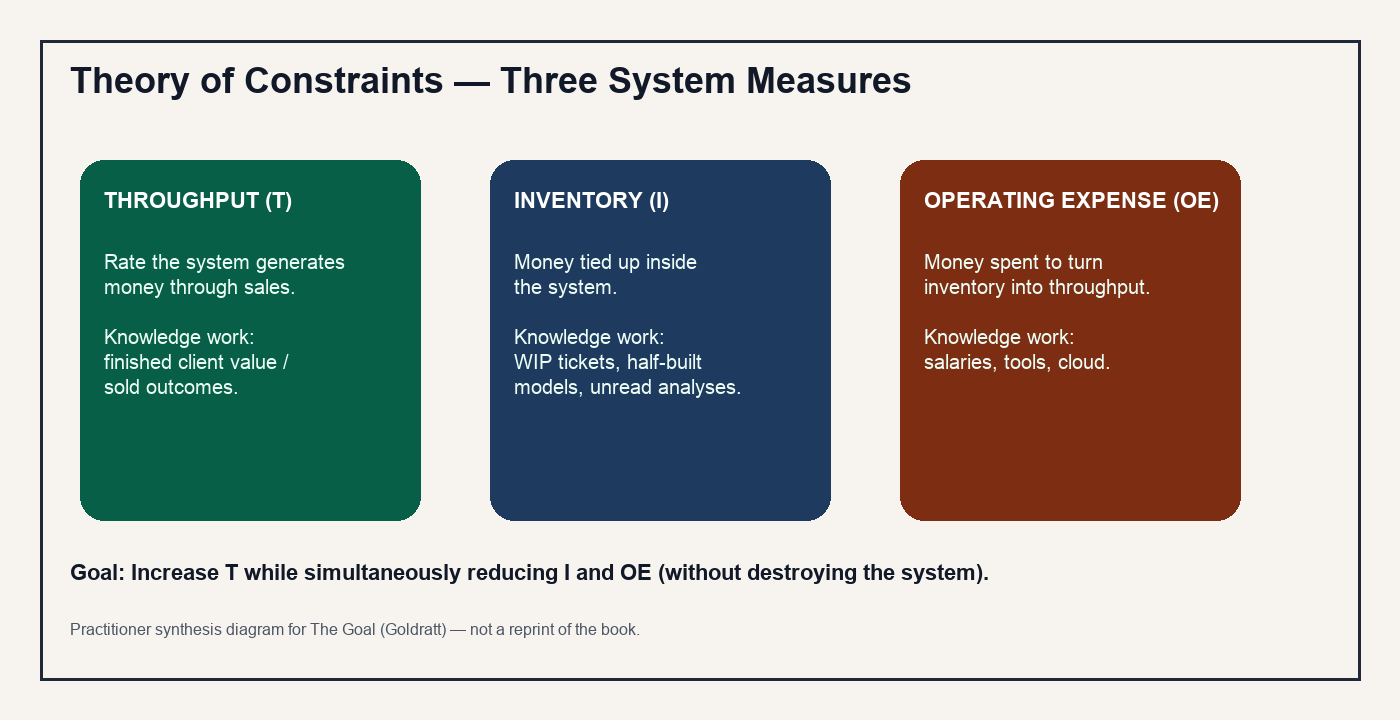

Three system measures framework

Figure: practitioner framework for Throughput, Inventory and Operating Expense (educational synthesis of Goldratt).

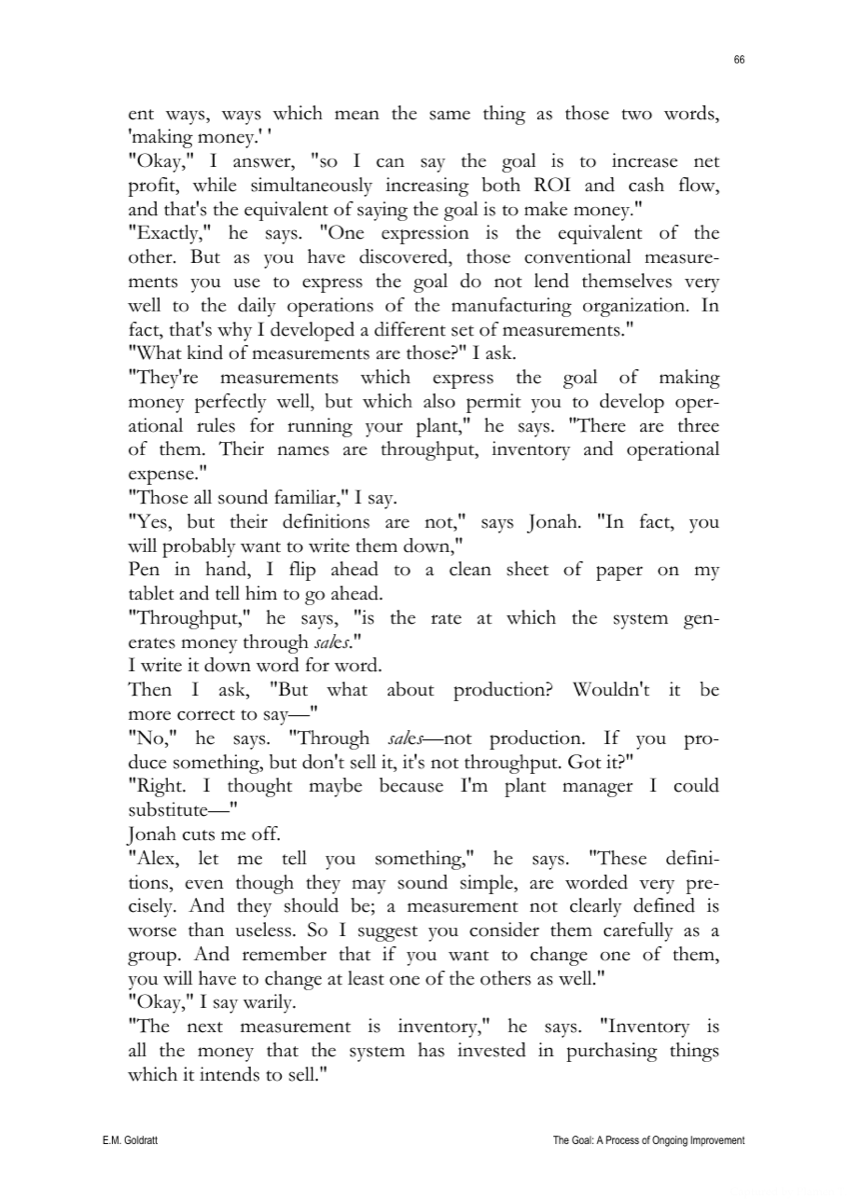

Book page — T / I / OE discussion

Figure: educational illustration from The Goal—Jonah introduces the three measures.

MeasurePlain meaningKnowledge-work analogue
Throughput (T)Money generated by salesCompleted client value / shipped features that sell
Inventory (I)Money stuck in the systemWIP tickets, half-built models, unread analyses
Operating Expense (OE)Money to convert I → TSalaries, tools, cloud spend

2.1 Local optima trap

A team maximises its utilisation (looks productive) while increasing I and delaying T.

Local KPISystem effect
Analysts at 100% utilisationQueue before partner review explodes
Start every client request immediatelyWIP ages; nothing finishes
Buy more GPUsInventory of half-trained models rises
Hire juniors without senior review capacityQuality rework floods constraint

2.2 Accounting vs throughput thinking

Traditional cost accounting can punish exactly what helps throughput (idle time at non-bottlenecks, small batches). Goldratt challenges managers to ask whether a decision increases T—not whether it lowers a allocated unit cost on a report.


3. Dependent events and statistical fluctuations

Work flows through dependent steps. Each step has variability. Without buffers and constraint management, variability accumulates as queues and late delivery.

Implication: balancing capacity across all resources to 100% utilisation is a fantasy that creates chaos.

PhenomenonEffect
Fast step followed by slow stepQueue before slow step
Variability at each stepCompounds downstream
“Balance the line”WIP explosion

The hike metaphor (Herbie) makes this visceral: the troop’s speed equals the slowest scout’s speed—not the average.


4. Bottlenecks (constraints) defined

A bottleneck is any resource whose capacity is less than or equal to demand placed on it. Time lost on a bottleneck is time lost for the entire system.

On bottleneckOn non-bottleneck
Protect time fiercelyIdle time can be healthy
Quality before the constraintDo not flood the constraint with defective work
Extra capacity here raises TExtra capacity often only raises I
Never starve the constraintRunning “flat out” elsewhere wastes energy

4.1 Finding the constraint

Look at queues, not opinions:

  • Where does work wait longest?
  • Which role is always at capacity?
  • Which approval gate ages tickets?

Negative case: Declaring “engineering is the bottleneck” because headcount is low—while data never arrives from the client. The constraint may be client data access, not build capacity.


5. Five focusing steps (the TOC engine)

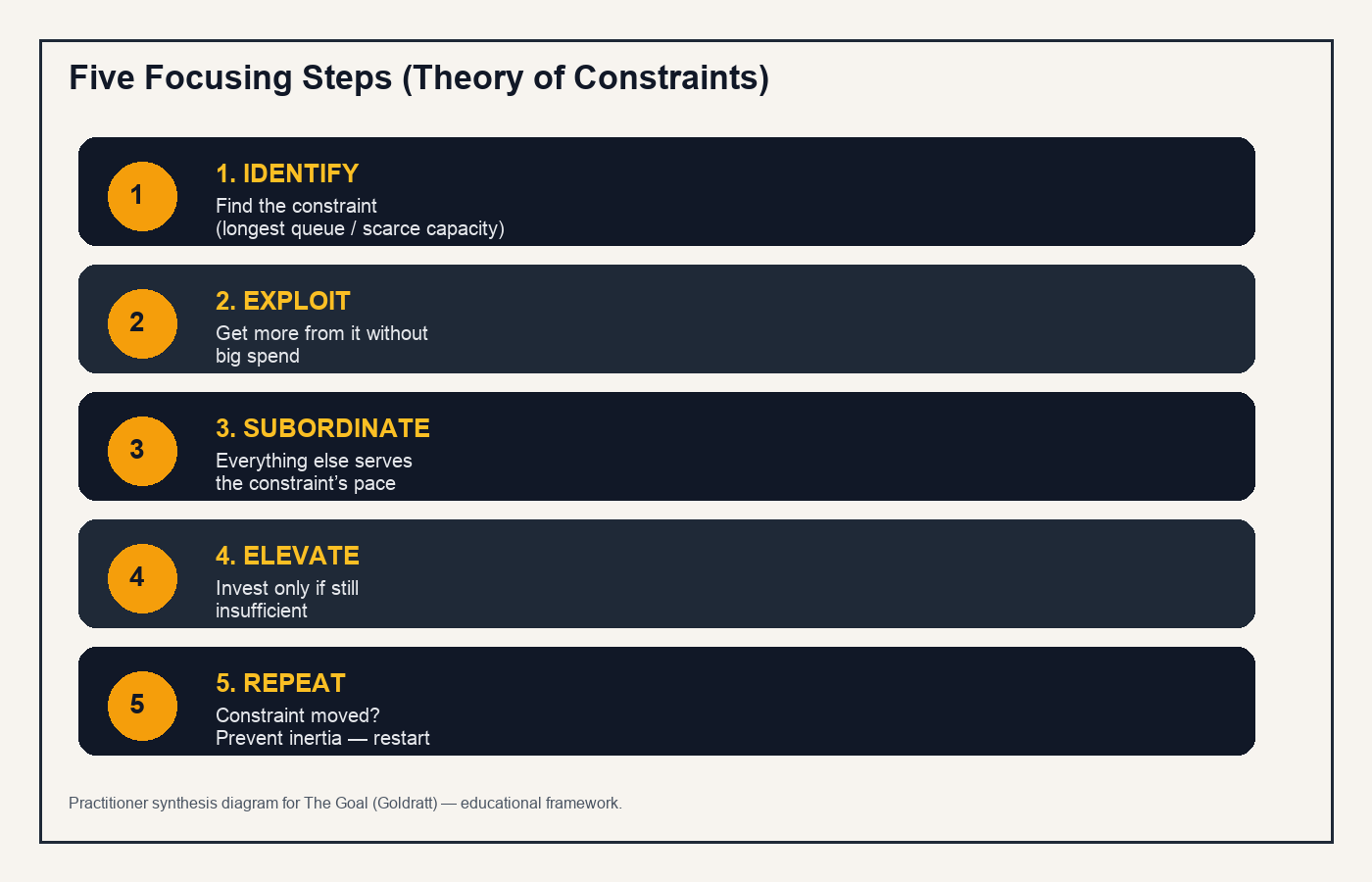

Five focusing steps framework

Figure: identify → exploit → subordinate → elevate → repeat (practitioner synthesis).

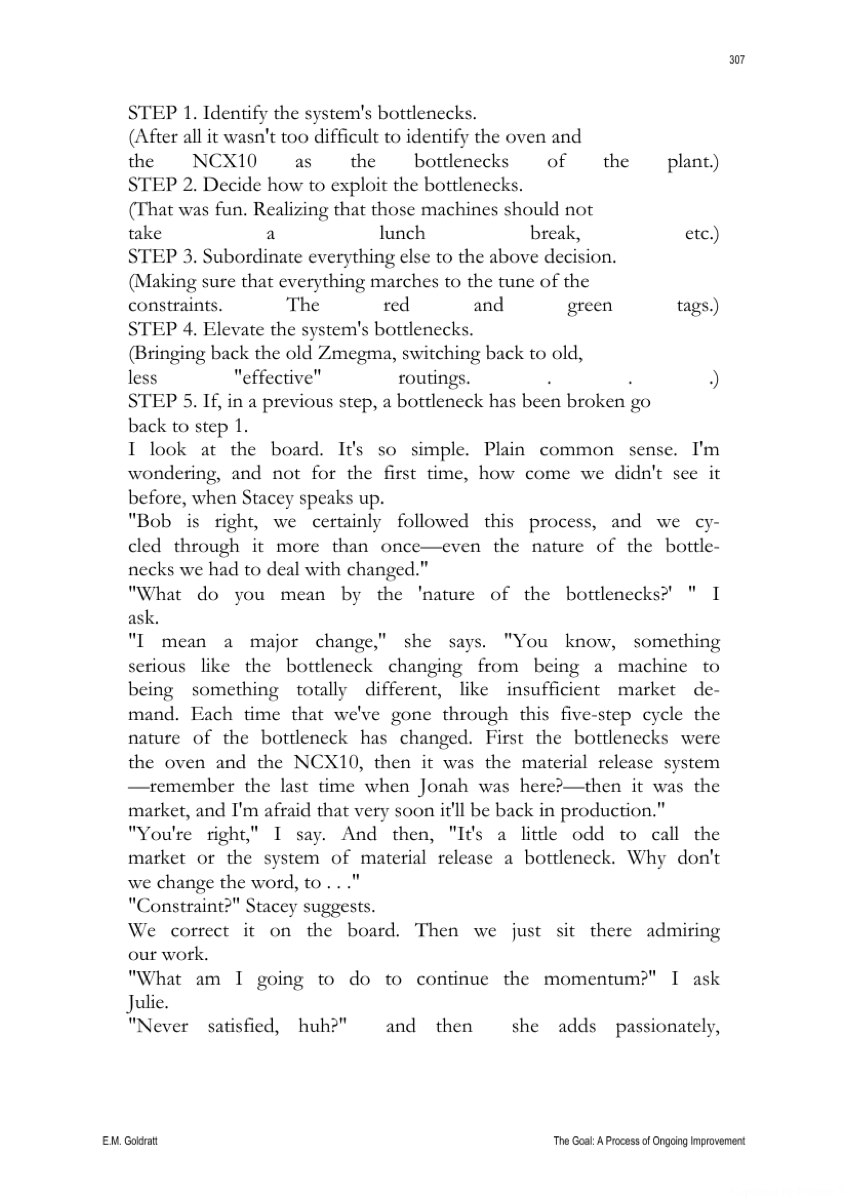

Book page — focusing steps context

Figure: educational illustration from later chapters of The Goal on the process of ongoing improvement.

5.1 Step 1 — Identify

Where does work wait? Which scarce skill or machine limits output? Use queue data and WIP age—not hallway consensus.

5.2 Step 2 — Exploit

Get more out of the constraint without big spend:

  • Improve quality into the constraint (no junk work arrives)
  • Ensure constraint is never idle (no meetings during drum time)
  • Prioritise highest-throughput work through the constraint
  • Offload non-constraint work from the constraint’s calendar

5.3 Step 3 — Subordinate

All other processes must serve the constraint’s pace. Non-bottlenecks should not run “as fast as possible.”

Subordinate actionExample
Release work at drum rateOnly N projects enter build per week
Pause low-value WIPKill zombie tickets blocking review
Align functional KPIsReward finished throughput, not starts

Failure mode: Announcing the constraint in a town hall but leaving individual bonuses on local utilisation.

5.4 Step 4 — Elevate

If still insufficient after exploit + subordinate, invest: add capacity, automate, hire, change technology.

Rule: Do not elevate before exploit. Buying GPUs before fixing eval queue is elevation theatre.

5.5 Step 5 — Repeat (inertia warning)

When the constraint moves, policies that protected the old constraint become harmful. Re-diagnose monthly.


6. Drum-Buffer-Rope (DBR)

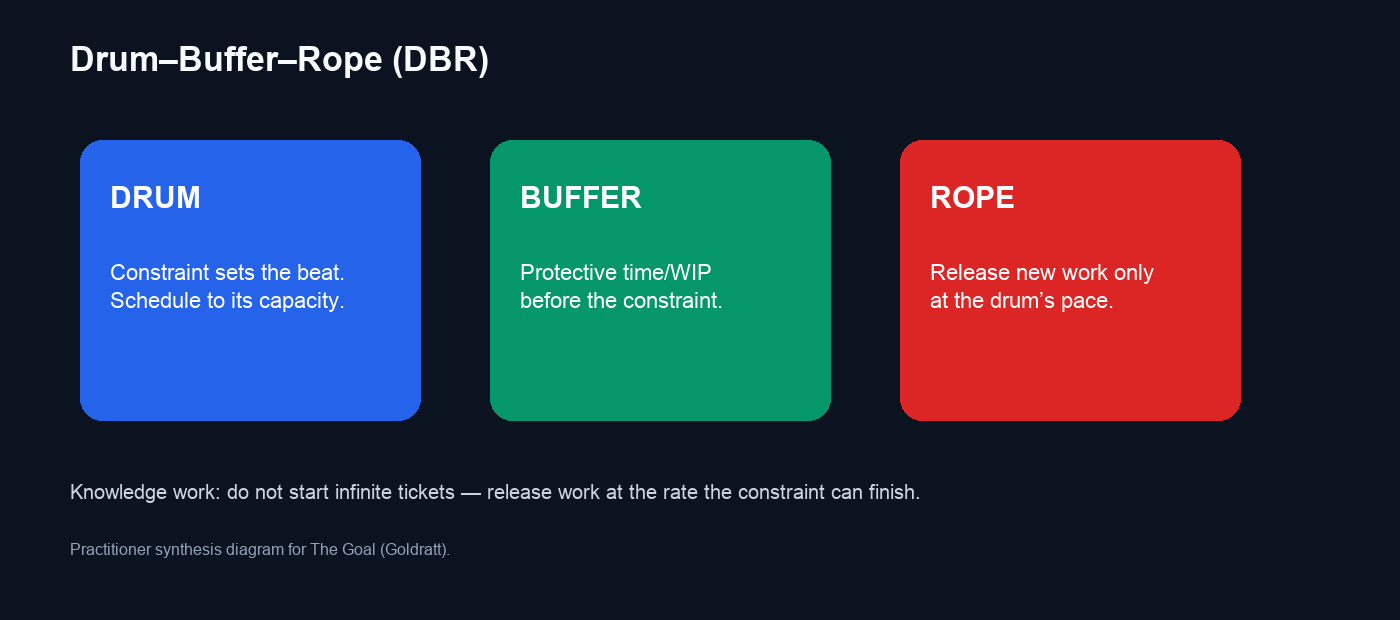

Drum–Buffer–Rope framework

Figure: schedule to the constraint, protect it with a buffer, and rope new work releases to its pace.

ElementRole
DrumConstraint sets the beat (schedule)
BufferTime/protective inventory before the constraint
RopeRelease of new work tied to the drum so WIP does not explode

Manufacturing intuition: Do not release material faster than the bottleneck can process.

Knowledge-work DBR: Do not start infinite tickets; release work at the rate the constraint (principal review, security sign-off, GPU eval) can finish.

6.1 Buffer management

Buffers are not waste—they absorb variability before the constraint starves. Monitor buffer consumption:

Buffer stateAction
HealthyContinue drum pace
Consuming fastExpedite upstream quality; protect constraint
EmptyConstraint will starve—stop new releases

7. Herbie and the hike — intuition pump

In the novel, a slow scout (“Herbie”) paces the troop: putting him at the front and redistributing load increases the group’s speed. System speed equals constraint speed—after you help the constraint.

Hike lessonOperations lesson
Help HerbieExploit constraint
Don’t push from the backSubordinate non-bottlenecks
Pack weight off HerbieQuality in before constraint

8. Novel arc — key plot lessons (synthesis)

Goldratt spreads theory across ~40 chapters. Practitioners extract these recurring beats:

Story beatTOC lesson
Late orders despite busy plantLocal efficiency ≠ throughput
Batch size debatesSmaller batches often help flow
Quality at bottleneckDefects at constraint are catastrophic
Marriage subplotSystems thinking applies beyond factory
Promotion pressureShort-term cuts can destroy T

You do not need the novel’s every romance scene for operations work—but the emotional resistance to idle machines is the same resistance to “waiting” knowledge workers.


9. Applying TOC to consulting delivery

9.1 Typical constraints

DomainCommon constraint
ConsultingPartner review hours; client decision latency
SoftwareIntegration/test environment; senior design review
GenAI deliveryEvaluation / red-team capacity; data access approvals
Sales+deliveryScarce SME for pursuits

9.2 Exploit examples

  • Pre-check deliverable quality before partner review
  • Standardise templates so review is faster
  • Batch client decisions in steering (reduce setup waste)
  • Kill low-throughput WIP that blocks the constraint

9.3 Subordinate examples

  • Stop starting new workstreams without partner capacity
  • Delay non-critical internal projects consuming SMEs
  • Align sales promises to drum capacity

9.4 Metrics to watch

Instead ofPrefer
100% utilisationThroughput of finished value
Tasks startedCycle time / WIP age
Local team velocity onlySystem queue before constraint
Billable hoursCash collected / extensions

10. Applying TOC to AI pipelines

10.1 Common AI constraints

StageOften constrained by
DataAccess, labelling, governance approval
TrainingGPU quota—not always the real constraint
EvaluationRed-team / domain expert review
ProductionChange advisory board, security sign-off
AdoptionClient change management bandwidth

10.2 Exploit without buying more GPUs

  • Pre-validate datasets before ML engineer time
  • Shared eval harness (constraint does not redesign tests per model)
  • Automated smoke tests before human eval
  • Tiered review: quick screen → deep review

10.3 Rope rule example

“No new model enters human eval until prior eval queue ≤ 5 items.”


11. Negative cases (expanded)

FailureSymptomFix
Bottleneck without evidenceRandom “fix engineering”Queue measurement
Elevate before exploitTooling spend; same delaysExploit checklist first
Subordinate not enforcedWIP flood returnsRope policy with teeth
Cost accounting myopiaCut constraint protectionT-first decisions
Constraint moved invisiblyOld policies harm new flowMonthly re-identify
Fake constraintOptimise easy stepFollow the queue

Health checklist

  • Constraint named with queue evidence
  • Exploit actions listed before budget requests
  • WIP release policy (rope) written
  • Buffer monitored (not infinite)
  • Monthly re-identify constraint

12. Consulting engagement translation

Client symptomTOC diagnosisIntervention
“Everyone is busy, nothing ships”High I, low TIdentify constraint; rope
“Quality issues at go-live”Defects hitting constraint lateQuality before constraint
“We need more headcount”Maybe—or wrong exploitExploit before elevate
“Agile velocity up, revenue flat”Local optimaSystem throughput metric

Pair with Disciplined Entrepreneurship: scaling (Step 24) before unit economics work is elevating a broken drum.


13. Capstone — one-week TOC sprint

  1. Map the value stream for one offer.
  2. Measure wait times at each step for five items.
  3. Name the constraint with data.
  4. List three exploit actions; execute this week.
  5. Write one rope rule; enforce it.
  6. Report T / I / OE proxies to the team.
  7. Schedule constraint re-identification in 30 days.

14. Novel chapter themes — practitioner map

Goldratt spreads theory across ~40 chapters. Use this map when reading or coaching teams:

Chapter bandPlot / themeTOC lesson
Early plant crisisLate orders, angry customersLocal efficiency fails
Jonah conversations“What is the goal?”T, I, OE framing
Boy Scout hikeHerbie slows troopConstraint sets system pace
Bottleneck discoveryWhere work piles upIdentify via queues
Quality debatesDefects before NCXQuality into constraint
Batch size fightsSmall vs large lotsFlow vs false economy
DBR implementationDrum, buffer, ropeRelease work to drum
Management inertiaOld policies after fixStep 5 — re-identify
Personal subplotMarriage under stressSystems thinking is personal

You do not need every narrative beat for operations work—the resistance to idle capacity is the cultural battle in knowledge work too.


15. Throughput accounting vs cost accounting (plain language)

Cost accounting habitThroughput thinking
Cut idle time everywhereIdle non-bottleneck can be optimal
Reward utilisationReward finished throughput
Allocate overhead to unitsAsk effect on T, I, OE
Buy cheaper machine on non-bottleneckInvest at constraint first

Consulting fee model example: Discounting to keep juniors at 100% utilisation while partner review queues grow increases I and delays T—even if margin per hour looks stable.


16. Multi-project portfolio TOC

When several client projects share one constraint (e.g. one architecture review board):

PolicyRationale
Single prioritised queueAvoid hidden multitasking at constraint
WIP limit per stageRope across portfolio
Kill or pause lowest-T projectsExploit constraint time
Buffer before steering gatesAbsorb client schedule variability

Pair with High Output Management for managerial leverage at the constraint.


17. AI factory extended example

StageQueue signalExploit (no new budget)
Data ingestTickets waiting on legalPre-approved template contracts
Feature engIdle waiting for labelsActive learning sampling
TrainingGPU queue longSchedule off-peak; smaller experiments
EvalRed-team backlogAutomated regression first
DeployCAB monthlyPre-approved patterns library

Rope example: “Maximum three models in human eval at once.”


18. Exploit tactics catalogue (by constraint type)

Constraint typeExploit tactics (before elevate)
Partner reviewPre-review checklist; delegate L1 review
Client decisionBatch decisions; exec sponsor cadence
Security sign-offPre-approved patterns; shift-left scans
Data accessTemplate DPA; synthetic data for dev
GPU quotaSmaller experiments; off-peak scheduling
Expert evalAutomated regression; tiered human review

19. Subordinate policies — sample library

PolicyWhat it prevents
WIP limit per personContext switching
No-start rule without capacityRope violation
Kill tickets >30 days idleInventory bloat
Single prioritisation queueConstraint starvation
Freeze non-critical internal workSME drain

Enforce subordinate before buying capacity (elevate).


20. TOC in agile / kanban language

Agile conceptTOC translation
WIP limitsRope + buffer
Cycle timeSystem flow to throughput
VelocityDangerous if local—watch constraint queue
Stand-up blockersOften queue before constraint
Sprint commitmentMust match drum capacity

Negative case: Team velocity up 40%; releases still late—constraint moved to CAB and nobody re-identified.


21. Executive steering narrative (consulting)

When client leadership celebrates utilisation:

  1. Show queue chart before constraint (Situation).
  2. Show delayed throughput £ impact (Complication).
  3. Recommend exploit + subordinate before headcount (Answer).

Use Minto SCQA + one SWD queue chart.


22. Monthly TOC operating rhythm

WeekActivity
1Measure WIP age by stage
2Re-identify constraint
3Implement one exploit action
4Review buffer consumption; adjust rope

23. Goldratt follow-on reading (TOC body of work)

WorkExtends The Goal by…
It's Not LuckThinking processes; conflict resolution
Critical ChainProject management at constraint
Necessary but Not SufficientERP / software as constraint illusion
The ChoiceTOC as life philosophy

For consulting PMOs, Critical Chain pairs directly with multi-project Section 16.


24. Constraint elevation decision tree

Constraint identified & exploited?
No → return to Step 2 Exploit
Yes → subordinate enforced 2+ weeks?
No → enforce rope/WIP limits first
Yes → throughput still insufficient?
No → monitor; prevent inertia (Step 5)
Yes → elevate (hire, automate, buy)

Do not skip branches—especially subordinate before elevate.

Discussion

Comments

Share feedback or questions about this page. No account required.

Loading comments…
